Engineer Technical Data Sheet • Refusal + Proof-Lift Capacity Verification

FMPP25 Push Pier System

Hydraulically advanced deep foundation underpinning system engineered for controlled axial load transfer, stabilization, and precision elevation. Capacity is confirmed in real time by measurable structural lift and correlated hydraulic pressure, with documented installation pressures per pier location.

Rated Working Load: 20 tons (40,000 lb) Suggested Ultimate: 25 tons (50,000 lb) Pier Shaft: 3″ Sch 40 (NPS 3) • ASTM A252 Gr 2 Section: A=2.24 in² • I=2.20 in⁴ • S=1.26 in³ Acceptance: Refusal = sustained pressure + measurable lift

Engineering verification basis: axial stress (σ = P/A) and conservative Euler buckling review (Pcr ≈ 69 tons @ L = 60″, K = 1.0). Mechanical lock inserts are field-cut for true steel-to-steel bearing; shimming is not used as a primary load path.

FMPP25 Push Pier System Technical Brochure
FMPP25 Push Pier System • Technical Specifications • Capacity Verification Click Image to Enlarge
Florida Foundation Authority

Florida’s Longest-Running Foundation Repair & Structural Engineering Firm

For more than 25 years, Foundation Masters has designed, engineered, and installed foundation repair, underpinning, deep foundation, waterproofing, and structural stabilization systems. As Florida’s longest-running foundation repair company under continuous ownership, Foundation Masters continues to provide engineered solutions backed by decades of field experience, documented project performance, and proprietary foundation systems developed specifically for Florida conditions.

Engineer Design Reference

Select a pile system to review specifications, installation criteria, and engineered acceptance guidance. Use this index to compare options and keep design decisions consistent across projects.

System Selector • Spec Pages

Verification-Based Acceptance — Documented in the Field

FM-PP25 acceptance is based on measured hydraulic load and observed lift at refusal, with documented pressures per pier location. This produces a defensible underpinning outcome under real site conditions, without relying on torque correlation.

*Administered per contract terms, access conditions, safety constraints, and project-specific engineering evaluation. Refer to the PDF data sheet for procedure and acceptance criteria.

System Overview

FM-PP25 is advanced to refusal by hydraulic press force reacting against the structure. When sustained installation pressure produces measurable structural lift, the pier has achieved the required working capacity. This creates a measured, defensible underpinning outcome under real site conditions.

Refusal + Proof Lift

Segments are pressed until soil resistance produces the required pressure. Proof is confirmed by lift initiation and hold criteria using calculated load with displacement checks.

Designed for Retrofit & Tight Access

Compact footprint and stackable segments make FM-PP25 ideal where access, overhead clearance, or disturbance must be minimized.

Construction

FM-PP25 uses 3″ Schedule 40 steel pipe (NPS 3) with ASTM A252 Grade 2 material (Fy = 35 ksi). Capacity is established in the field by measured hydraulic load and lift confirmation at refusal. A mechanical locking assembly is installed for true bearing engagement—no shimming permitted as a primary load path.

Engineering Verification

Working load is verified by hydraulic pressure and observed lift at refusal. Steel stress check is performed using the pipe steel area.

  • Steel Area: 2.24 in²
  • Working Stress: 40,000 / 2.24 = 17.9 ksi
  • Suggested Ultimate Stress: 50,000 / 2.24 = 22.3 ksi
  • Buckling: Euler critical ≈ 69 tons

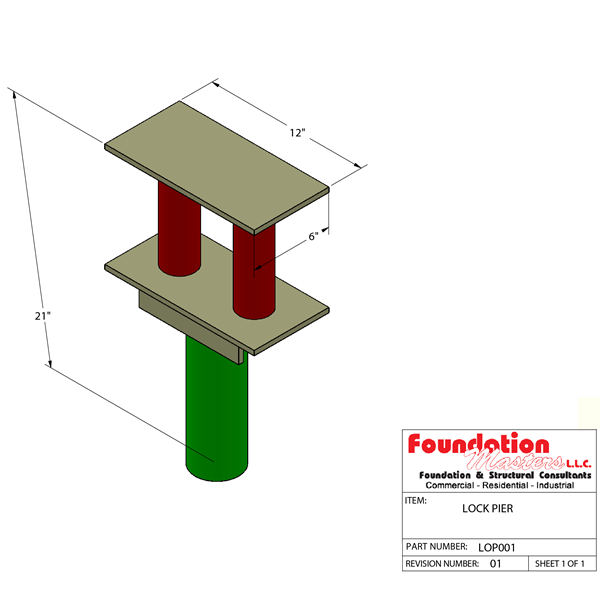

Mechanical Locking / Preload

After refusal and proof-lift, the system is locked in bearing using a mechanical assembly and preload jack procedure.

  • 6″×6″×1/4″ tube + 6″ channel
  • 20-ton preload jack procedure
  • (2) 2″ Sch 40 inserts
  • No shimming as primary load path

For complete procedure, acceptance criteria, and verification details, download the engineer PDF at the top of this page.

Technical Specifications

Pier Type
Hydraulically driven resistance push pier; refusal-based installation
Pipe Material
ASTM A252 Grade 2 (Fy = 35 ksi)
Pipe Size
3″ Schedule 40 (NPS 3)
Pipe O.D.
3.500 in (88.9 mm)
Wall Thickness
0.216 in (5.49 mm)
Steel Area
2.24 in²
Moment of Inertia
2.20 in⁴
Section Modulus
1.26 in³
Rated Working Load
20 tons (40,000 lb) verified by proof-load and lift criteria
Suggested Ultimate
25 tons (50,000 lb)
Advancement Equipment
30-ton hydraulic ram
Segment Length
12″ nominal stackable segments
Connections
Full-penetration welded • threaded coupler • coupler joint
Refusal Definition
Sustained hydraulic pressure producing measurable structural lift
Mechanical Locking
6″×6″×1/4″ tube + 6″ channel with 20-ton preload; no shimming as primary load path
Corrosion Protection
Within 12″ of grade: zinc-rich cold galvanizing + protective enamel topcoat
Embedment
To refusal, verified by hydraulic pressure and lift
Warranty
Lifetime, transferable, per contract terms and conditions

Note: Final load rating and lift feasibility depend on structure condition, access, and project-specific engineering evaluation.

Components & Field Documentation

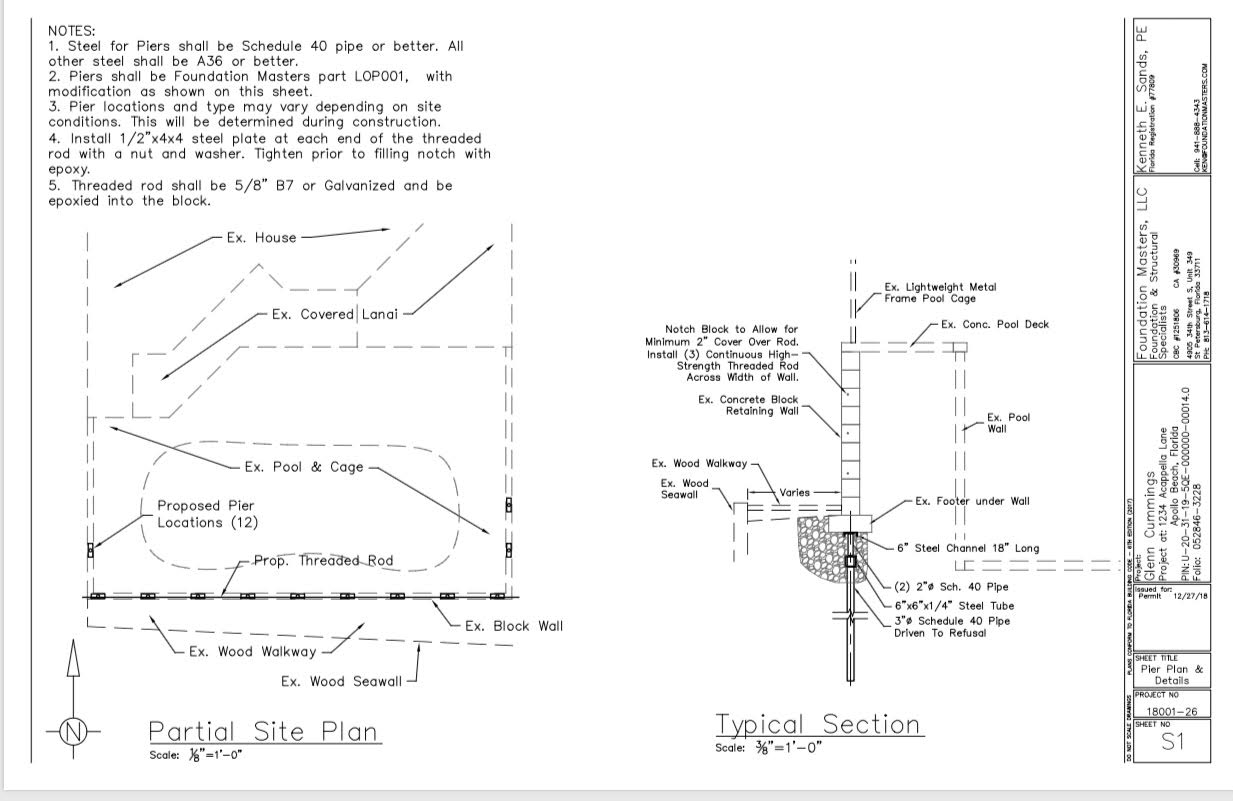

Engineer-Sealed Installation Detail

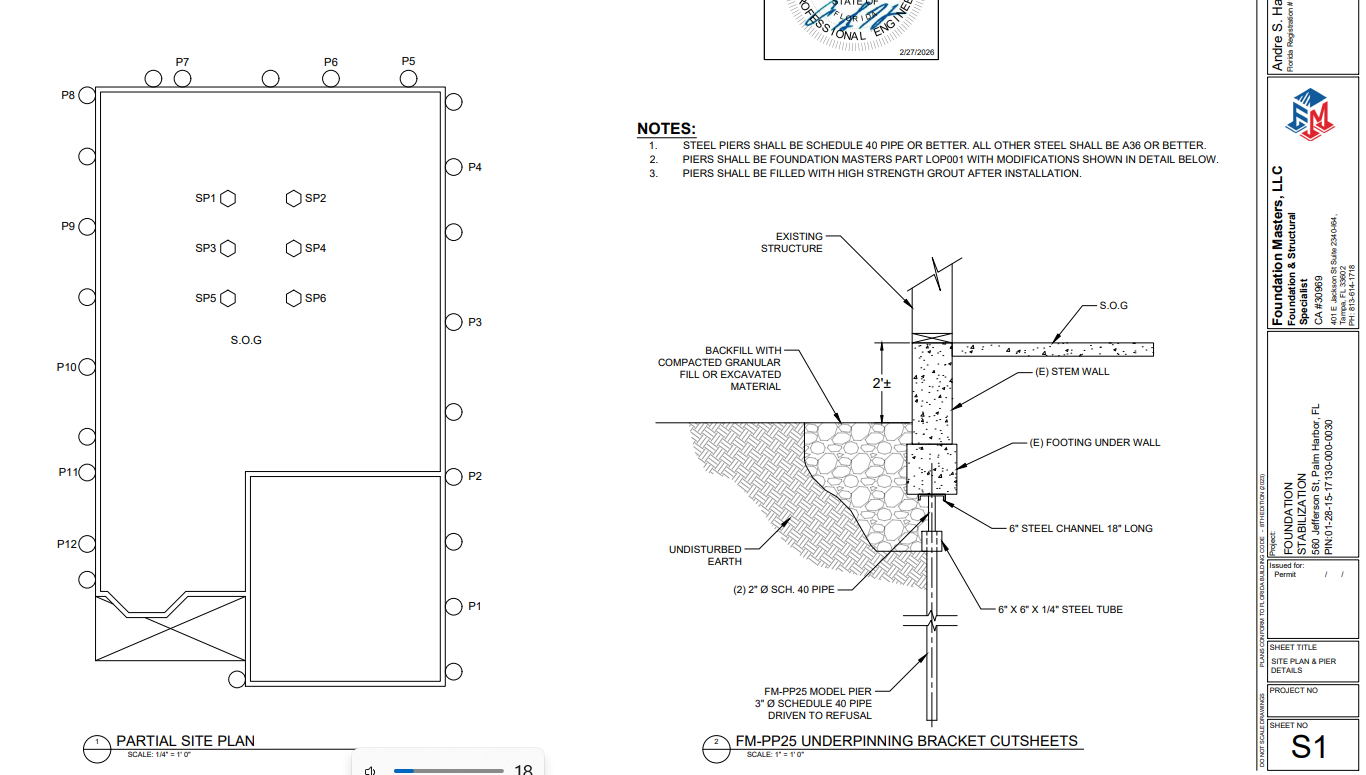

FM-PP25 Push Pier Underpinning Bracket and FM-PP30 Slab Pier Engineering Detail

Engineer-sealed installation detail illustrating the FM-PP25 exterior underpinning bracket assembly and FM-PP30 interior slab pier stabilization configuration. Click the drawing to review the complete engineering plan set.

Proven Field Performance

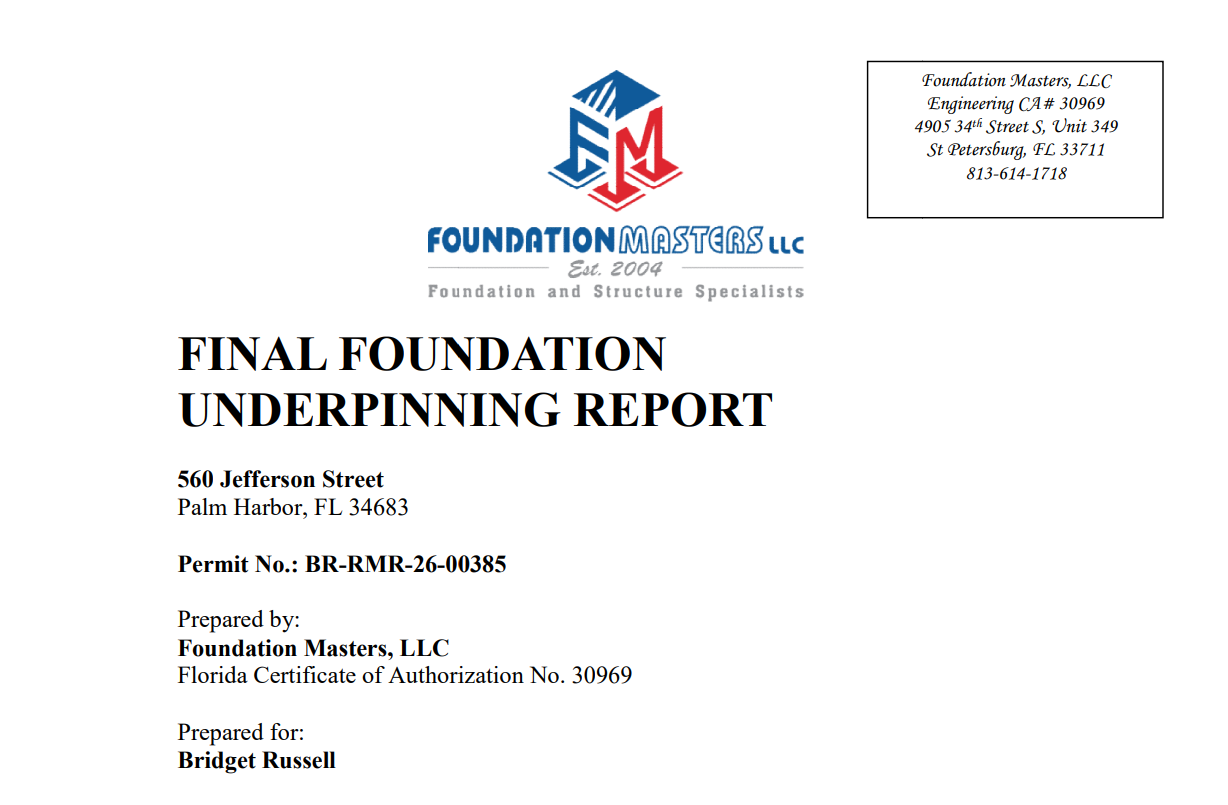

Foundation Masters Final Underpinning Report Showing Installation Depths Pressures and Lift Verification

Actual Foundation Masters underpinning project documenting pier locations, installation depths, hydraulic installation pressures, lift verification, and final engineering acceptance. Click the report preview to review the complete project report and installation data.

All images below display full-frame for clean technical presentation.

FM-PP25 Push Pier vs. Helical Retrofit Systems

Category
FM-PP25 Push Pier
Helical Retrofit Systems
Verification Basis
Measured hydraulic proof-load and lift confirmation at refusal
Torque correlation and embedment criteria
Primary Use
Underpinning where structure provides reaction; constrained access
Compression/tension applications where torque verification is preferred
Capacity Takeaway
Working capacity is demonstrated under load during installation
Capacity is inferred from installation parameters
Lock-In / Engagement
Mechanical lock + preload procedure to maintain true bearing
Bracket and connection vary by system and field condition

Values shown are representative and may vary by site conditions. Always consult project-specific engineering.
